Dubai new projects: how to read DLD project-status fields
In the DLD project-status record captured on 27 September 2026, Avarra By Palace showed 0.08% completion, tied to an inspection dated 10 June 2026, and a separate stated completion date of 30 June 2031. Those fields answer different questions: the record identifies a registered project and a dated technical observation, but it does not establish when a buyer's unit will be handed over.
Read the DLD screen as separate evidence

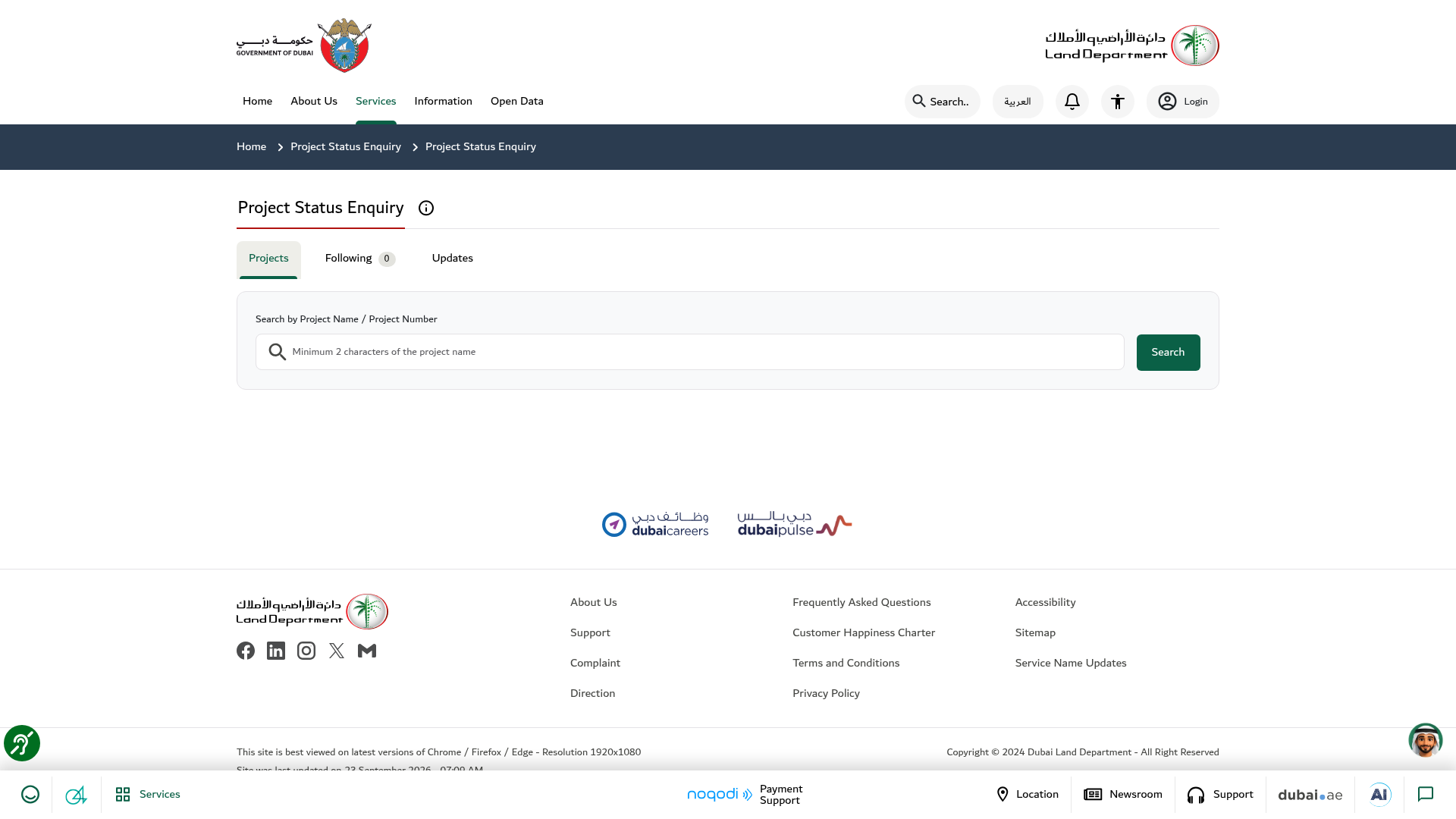

DLD Project Status is best read as a bundle of fields, each with its own date and scope. The official service overview says the tool lets a customer inquire about a Dubai project's completion percentage and details. A search can use a land number, project number or project name.
The interface then brings several records into one view. It can show the project number, registration date, start date, status, units, completion percentage, completion date, developer and escrow fields. DLD's Dubai REST description also lists completion percentage, actual project pictures and escrow account number among its off-plan project information, as checked on 27 September 2026.
The placement of these values on one screen does not make them interchangeable. Registration identifies a project in the official system. Status reports a current label. Progress reports a dated technical observation. The completion-date field states a date in the record. Escrow identifies a project account. Handover concerns the buyer's actual unit and documents.

A current official example shows what each field can prove
The current record for Avarra By Palace, project 4227, is useful because its official DLD result exposes every major field needed for this method. The values below were captured from DLD on 27 September 2026. They are field values, not a verdict on the project or developer.
The practical reading is narrow and useful. Project 4227 appeared under that name with those values on the capture date. Any conclusion about a particular purchase has to add the buyer's executed documents and current unit-level evidence.

Progress percentage belongs to an inspection date
The percentage is a dated technical record, not a continuously updating forecast. DLD's official FAQ says project progress can be confirmed through the latest approved technical audit and the project-tracking service. The same FAQ says expected completion dates and completion rates are technical project data reviewed periodically, as checked on 27 September 2026.
The current project 4227 result exposed two inspection entries:
The subtraction is 0.08% minus 0.00% = 0.08 percentage points. The calendar interval from 18 November 2025 to 10 June 2026 is 204 days. Both results were recomputed from the official inputs in the draft's replayable verification file.
Those two numbers describe the visible inspection history. They do not provide a construction speed, a monthly rate or a forward estimate. As of the 27 September 2026 capture, the latest visible inspection itself was dated 10 June 2026, which is why the date belongs beside every mention of 0.08%.

Escrow proves a project-account link, not handover
An escrow field can establish a project-account match at the time checked. It cannot establish the other records around the purchase.
DLD's official FAQ defines the real-estate escrow account as the project bank account into which amounts collected from off-plan purchasers and project financiers are deposited. DLD's project-registration service also describes registration and opening an escrow account for off-plan sales as connected developer procedures, as checked on 27 September 2026.
For Avarra By Palace, the captured DLD result named Emirates Nbd Bank (P.J.S.C) and displayed an account ending 8537. That supports a character-by-character comparison against the payee instructions in the buyer's current document pack. The full account number is intentionally not republished here.
The result does not expose a balance, a statement of recent activity or the terms of the buyer's sale and purchase agreement. It also does not connect the project-level account to a handover appointment for one unit. The sibling official escrow verification route sets out the full identity, developer, permit and account sequence.
Stated completion and actual handover are different records
The completion-date field is a date in the project record. Actual handover is a buyer-specific event supported by a different document trail.
The cleanest sequence is to read the stated completion field beside its capture date, then check the executed sale and purchase agreement for the buyer's contractual terms. Any current developer notice should be kept as a separately dated record. A unit inspection or snagging record concerns the particular unit, while keys and access concern the handover event itself.
The title stage is separate again. DLD's service for completing provisional procedures says compliant parties can use Oqood, Dubai's provisional registration system for off-plan transactions, to issue a Certificate of Title or title deed. That service description was checked on 27 September 2026. It shows why a project completion field and the later title process should not be treated as the same evidence.
This separation is also useful when comparing launch material. The cluster's launch-price and area-evidence method begins with verified identity and dated project records before it compares price evidence. A price comparison cannot fill a missing handover record.
Use a five-step project-status check
The repeatable method starts with identity and ends with the buyer's own file. It does not ask one official screen to answer every purchase question.
Match the exact project
Search DLD Project Status by the exact project name or project number. Save the number, registered developer, status and capture date. A similar marketing name is not a substitute for an identifier match.
Attach the inspection date
Copy the completion percentage with the date of the inspection that produced it. If the interface shows older inspections, keep them as separate rows rather than blending them into a trend.
Reconcile the escrow fields
Compare the bank and account identifier shown by DLD with the current written payment instructions. Keep the project name and number beside that comparison.
Read the contract on its own terms
Use the executed sale and purchase agreement for the buyer's milestones, notices and contractual dates. The payment-plan clause worksheet shows how to keep calendar triggers and construction-linked triggers separate.
Build the unit-level handover file
Keep current developer notices, unit inspection or snagging records, handover communication, keys or access record and the later title documents together. These records answer the unit question that the project-level status screen does not.
What are the upcoming projects in Dubai?
As of 27 September 2026, portal and developer launch pages can help identify names, but the official DLD Project Status service is the place to match a Dubai project name or number to its current project record. A launch listing and a DLD status record answer different questions.
What are the upcoming projects in the UAE for 2026?
The DLD service covered here is for real-estate projects in Dubai, not a UAE-wide launch directory. Its completion-date field should be read as a dated project value, not as confirmation of an individual unit's handover.
What is the latest development in Dubai?
As of 27 September 2026, “latest” depends on the record being checked. A launch announcement identifies a new offer, while DLD Project Status provides a project-level status, inspection and escrow record with its own dates.
