Dubai move-in inspection record: evidence by defect type

Dubai move-in inspection record: evidence by defect type

Posted on byLida MoghaddamLida Moghaddam

Disclaimer: This article is for general informational purposes only. It is based on cited public data and published under Lida Moghaddam's RERA-licensed masthead. It is not financial, legal, or investment advice. Dubai's property market moves quickly, so figures, yields, and rules may change or become outdated by the time you read this. Verify current information with the relevant authority or a qualified professional before acting. Read the full disclaimer.

Table of contents+

As of 29 September 2026, the Rental Disputes Center's first-instance rental page lists four numbered core document groups, then invites supporting records such as correspondence, notices, utility bills, cheques and letters. A move-in inspection is most useful when it keeps each visible condition tied to a room, date, source file, notice trail and open question, without treating a photograph or worksheet as proof of cause, liability or a later deduction.

Start with the job of each record

The useful distinction is between what a record contains and what someone later concludes from it. Dubai's official unified tenancy contract records the parties, property, term, annual rent, deposit and payment method. It also allows additional terms in an addendum signed by the parties. Neither the contract nor the addendum is the same thing as a room-level observation log (DLD unified tenancy contract, accessed 29 September 2026).

The Dubai tenancy contract guide explains the wider lease structure. The table below keeps seven records in their proper lanes.

RecordWhat it can recordWhat it does not decide by itself
Tenancy contractParties, property, lease dates, rent, deposit and agreed obligationsThe detailed visible condition of every room on handover
Signed addendumExtra terms agreed by the parties, provided they do not conflict with lawWhether a later mark was caused by one party
Handover checklistItems inspected, observations, keys, readings and acknowledgementsCause, legal responsibility or the amount of a future claim
Dated imageVisible condition in a particular file and its recorded date contextAuthenticity, cause, responsibility or a future deduction without supporting context
Maintenance reportThe inspection, diagnosis, work or recommendation stated by its issuerA tribunal's finding or a conclusion beyond the report's own scope
Notice and delivery recordWhat was communicated, when, by which channel and with which attachmentThat the recipient agreed with every statement in it
Later RDC claim fileThe lease, identity, banking, notice and supporting documents submitted for a stated claimThe outcome or evidential weight the RDC may give any one item

The official contract says an addendum may be attached when additional terms are needed and signed by the contracting parties. It does not publish a mandatory move-in checklist. The worksheet below is therefore an editorial tool for organising records, not a substitute for the contract, Ejari registration or an RDC filing requirement.

Use a room-and-defect worksheet

The worksheet works best when one line describes one item or defect. That keeps a wall mark separate from an air-conditioning report, even if both sit in the same room. The six columns are an editorial classification by withlida, based on general evidence-keeping practice rather than an official DLD or RDC form.

Room or itemObservationDate and timeDocument or fileNotice statusUnresolved question
Entrance, door and locksDescribe visible marks, alignment and operation without naming a causeRecord the inspection or capture timeChecklist line, wide image, close image, key sheetNot sent, sent, received or answeredWas this present at handover, and is any action agreed?
Walls, ceilings and floorsDescribe location, size and visible character of a mark, crack, chip or stainUse the date attached to the actual recordRoom plan, image filename, inspection pageLink the exact line and attachmentDoes another record establish history or cause?
Windows and balcony doorsRecord visible seal, glass, frame, handle and opening conditionNote inspection time and any later recheckWide view, detail image, maintenance reportRecord recipient and responseIs the issue cosmetic, operational or still unclassified?
Kitchen and appliancesRecord item identity, visible condition, serial number and observed operationDate the observation and any technician visit separatelyInventory, image, video index, reportLink notice to the exact applianceWhat does the contract or inventory say was supplied?
Bathrooms and water-related marksDescribe only what is visible or measured, including location and extentKeep move-in capture and later report dates separateImage, checklist, plumber or maintenance reportRecord when the issue was reportedHas a qualified report stated a source, and what remains unknown?
Cooling, power and controlsRecord the control, display or function observed at the timeNote test time and any service timeVideo index, meter image, maintenance recordRecord notice and access trailWas the system tested, inspected or repaired, and by whom?
Keys, cards, remotes and metersCount items and record displayed readingsUse the actual handover timeHandover sheet and labelled imagesShare the final count or readingDo both parties acknowledge the same handover figure?

For a wider start-to-finish folder, use the sibling Dubai tenancy deposit evidence checklist. This worksheet sits inside that file as the move-in condition layer.

Record a defect without deciding it

The clean method is to preserve an observation before turning it into an allegation. The sequence below is general knowledge for practical record keeping. It is not an official filing procedure and does not predict how the RDC will assess a record.

  1. Name the exact place and item

    Use the room, surface and fixture name that another person can locate. "Bedroom 2, wall beside window" is more traceable than "wall damage".

  2. Describe what is visible

    State colour, location, shape, approximate extent and observed operation. Keep cause words such as leak, impact or misuse out unless a qualified report or agreed record supplies them.

  3. Tie the observation to its source

    Give the checklist line, image filename, video timestamp, inventory item or report reference. A wide view establishes location; a closer view records detail.

  4. Separate the dates

    Keep the inspection date, image capture date, notice date, access date and maintenance-report date as distinct fields. Do not convert one into another.

  5. Record notice and response

    Link the exact observation and files sent. Record delivery or receipt separately from agreement. If the response disputes the entry, keep both positions.

  6. Leave the open question open

    Use a question field for missing cause, history, allocation or proposed action. Closing the question without a source removes the distinction the file is meant to preserve.

Five-part move-in condition evidence chain from observation to open question
Each defect line connects the visible observation to its date, source, notice trail and unresolved question.

One worked example shows the language boundary. "Small brown mark, about the width of the window latch, on the bedroom wall below the right corner of the window; visible in IMG-014 and room-wide IMG-013, captured 29 September 2026" is an observation. "The window caused a leak and the tenant is not responsible" is a conclusion that those two images do not establish.

Dubai Law No. 26 of 2007 sets the condition and maintenance boundaries relevant to this record. Article 15 was superseded by Law No. 33 of 2008, so the amended wording controls that row. The English legislation pages also state that the original Arabic text prevails if the translations conflict.

ProvisionWhat the official text statesBoundary for the worksheet
Article 15, as amendedThe landlord must hand over the property in good condition allowing the tenant full use stated in the lease (Law No. 33 of 2008, issued 1 December 2008)The worksheet can record the condition observed at handover. It does not decide whether the legal standard was met.
Article 16Unless the parties agree otherwise, the landlord is responsible during the lease for maintenance and repair of defects or damage affecting intended use (Law No. 26 of 2007, issued 26 November 2007)Record the lease term, report and response. Do not infer allocation without reading the agreement.
Article 17The landlord is responsible for defect, damage, deficiency and wear and tear arising for reasons not attributable to tenant fault (Law No. 26 of 2007, issued 26 November 2007)A condition image does not establish attribution. Keep any technical report separate.
Article 19The tenant must maintain the property as an ordinary person would maintain their own and needs landlord permission plus required licences for changes or works, subject to agreed or customary restorations (Law No. 26 of 2007, issued 26 November 2007)Record approvals and the exact work. Do not treat the inspection sheet as permission.
Article 20A landlord may take a security deposit for maintenance at lease expiry and must refund the deposit or remainder when the lease expires (Law No. 26 of 2007, issued 26 November 2007)The move-in record supplies condition context. It does not set a deduction.
Article 21At expiry, the tenant must surrender the property in the condition received, except ordinary wear and tear or damage beyond the tenant's control; a dispute goes to the Tribunal (Law No. 26 of 2007, issued 26 November 2007)Matched move-in and move-out records can show observed change. They do not decide which exception or responsibility applies.
Four-station legal boundary sequence for handover, maintenance, tenant care and surrender
The law supplies separate boundaries for handover, maintenance, tenant care and surrender.

The contract can change parts of the maintenance allocation where the law allows agreement. That is why the contract, addendum and condition record stay separate. The inspection sheet records facts. The signed terms record agreements. The law supplies the wider boundary.

Build any later RDC claim file separately

The move-in worksheet can become one supporting record in a later file, but it is not the claim file itself. As of 29 September 2026, the RDC first-instance rental service page lists four numbered core document groups: the latest lease or Ejari, identity evidence, a bank letter or statement showing the plaintiff's IBAN, and a notarised notice with the notification officer's report or registered post with acknowledgement for an eviction claim. It then gives examples of other supporting documents, including correspondence, notices, electricity and water bills, cheques and letters (RDC, accessed 29 September 2026).

The same page requires documents to be submitted in Arabic or legally translated into Arabic and uploaded in the sections described by the RDC system. That requirement belongs to the later filing stage. It does not turn the move-in worksheet into an RDC form.

For website filing, the current page lists five procedural steps: create or use an account and choose the service, enter data and upload documents, pay after electronic lawsuit verification, attend through the tele-litigation system, and receive the judgment through the website. These are published service mechanics, not a timetable or forecast for a result.

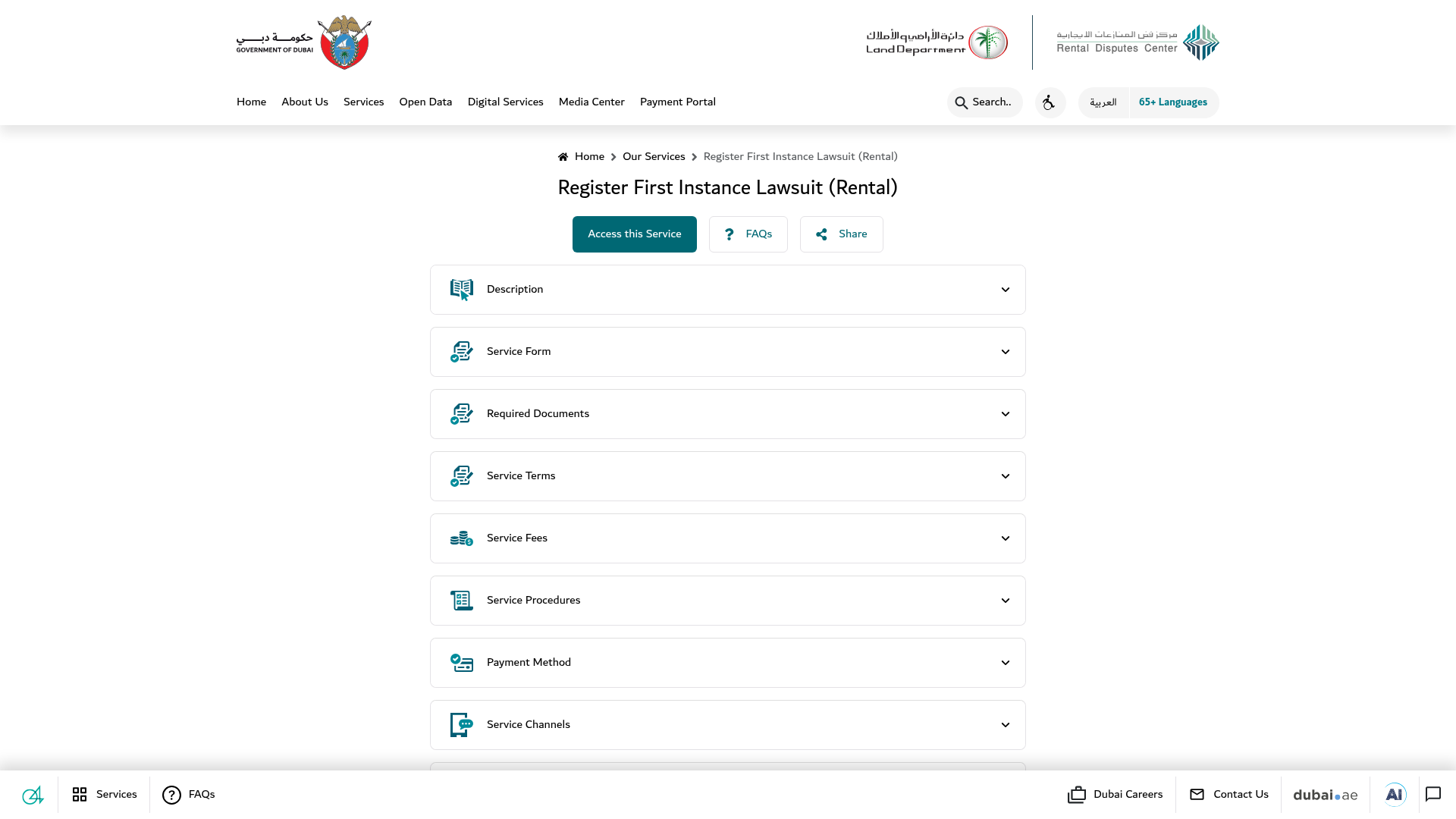

Rental Disputes Center first-instance rental lawsuit service page
The RDC page separates required documents, service terms and filing steps.

Before a later file is assembled, keep the record-level nouns exact:

File componentKeep asDo not relabel it as
Signed lease and EjariContract and registration recordRoom-condition schedule
Signed extra termsAddendumMaintenance report
Room worksheetHandover or condition checklistDLD or RDC form
Image or videoDated visual fileProof of cause or liability
Technician documentMaintenance or inspection report by its issuerTribunal finding
Message and delivery evidenceNotice trail or correspondenceAgreement unless the response says so
Uploaded case bundleRDC claim file for the stated claimPrediction of the outcome

The record is strongest editorially when another reader can follow its chain without repairing the labels: lease, addendum, observation, source file, notice, response, maintenance document and later claim bundle. The RDC decides its own process and assessment. The worksheet does not.

FAQ, checked 29 September 2026

Where can I file a complaint against a landlord in Dubai?

The official route is the Rental Disputes Center. Its first-instance rental service covers disputes arising between landlords and tenants and provides the current online and trustee-centre filing procedures (RDC, accessed 29 September 2026).

How can I resolve a rental dispute in Dubai?

The RDC page starts with the latest lease or Ejari, identity evidence, plaintiff IBAN evidence and the documents supporting the particular claim. An eviction claim has a specific notice and delivery-proof requirement on that page. The appropriate route depends on the claim and record, so the current RDC service classification needs to be checked directly.

What happens after an RDC rental claim is filed online?

As accessed on 29 September 2026, the service page lists data and document upload, payment after electronic verification, a hearing through the tele-litigation system and receipt of the judgment through the website. It labels registration completion as one business day, which is not the duration of the case or a result forecast (RDC).

How likely are you to win a rental dispute?

The official law and service page used here do not publish outcome odds. A checklist, photograph, report or notice may form part of a record, but withlida does not predict how the RDC will weigh it or decide responsibility.
